Utilities make agreements with customers and set a peak demand limit. This peak demand limit is called “Contracted Demand”. If the customer stays below the contracted demand, you get charged a fixed minimum charge usually in $/day. However, if you exceed this contracted demand, you get charged an excess penalty charge in $/kW/day or $/kVA/day in addition to the fixed minimum charge. To create a contracted demand rate, use the Contracted demand wizard under the demand rates tab.
Note: You can use this wizard only once, to add 1 set of contracted rates to your tariff. Using this wizard twice might have unintended consequences.

To enter the contracted demand, click the other tab under Demand, as shown below.

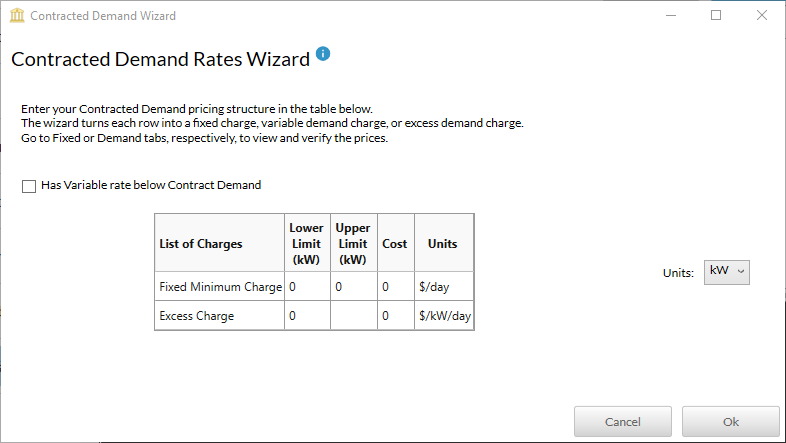

This would open up a pop-up, that would look like:
The pop-up window will have a table in it. Each row in the table represents a rate. The wizard turns each row into a fixed charge, variable demand charge, or excess demand charge. Go to Fixed or Demand tabs, respectively, to view and verify the prices.
By default (check box for variable limit is not selected), the table will create a simple contracted rate.
This option is the default option, and can be accessed if the checkbox for "Has variable rate below contract demand" is not selected. The table in this option will only have two rows. Each row will create a rate.
Step 2: Enter the minimum charge which is a per day charge.
If the customer stays below the contracted demand, then they will get charged this daily amount irrespective of what they consume.
Step 3: You can observe that the Step 1 auto-populates the lower limit for the second row.
You cannot enter the upper limit for the second row, since it defaults to Infinity, or in other words any demand above the contracted demand would fall in this category. Enter the excess penalty costs in $/kW/day.
If the customer exceeds the contracted demand, they get charged a minimum fixed charge in addition to this excess penalty charge.
The choices are kW, kVA and kVAR
Complex Contracted demand
Note: This option was built specifically to address the tariffs in Western Power, Australia. Please refer to this pdf , page no. 6-8. You can build western power's tariffs similar to RT7 using this option
You can access this option by checking the box (Has Variable rate below Contracted demand). Doing so, would change the table shown in the pop-up. The table will now have 3 rows.
Follow these steps to create the 3 rates:
Step 2: Enter the minimum charge which is a per day charge.
If the customer stays below the contracted demand, then they will get charged this daily amount irrespective of what they consume.
Step 3: You can observe that the Step 1 auto-populates the lower limit for the second row.
Enter the contracted demand in the Upper limit of the second row.
Step 4: Enter the variable cost in $/kW/day.
If the customer stays below the contracted demand but above the variable limit, then their cost = fixed charge + variable limit charge.
You cannot enter the upper limit for the second row, since it defaults to Infinity, or in other words any demand above the contracted demand would fall in this category. Enter the penalty excess charge in $/kW/day.
If the customer exceeds the contracted demand, then their total charge = excess penalty charge * Number of billing days.
The choices are kW, kVA and kVAR
Note: The difference between the simple and complex contracted demand is that in complex contracted demand, if the customer exceed the contracted demand, they do not get charged the minimum daily charge. In the simple case, if the customer exceed the contract, they get charged the minimum fixed charge in addition to the excess penalty. The complex contracted demand is a specific construct of the western power's tariffs like RT7.
Using the wizard will create multiple rates.
In case of the Simple contracted demand, you will find two new rates have been created for you:
(1) A fixed rate named "Fixed Minimum Charge" which can be found under the Fixed tab. This fixed rate has been created using your inputs to the first row in the table.

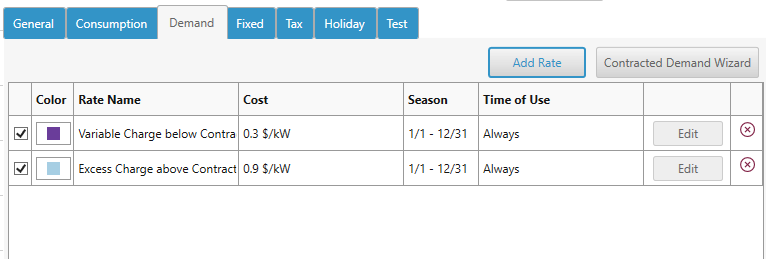

(2) A demand rate named "Excess Charge" which can be found under the demand tab. This demand charge has been created using your inputs to the second row in the table.
In case of the complex contracted demand, you will find three new rates have been created for you:

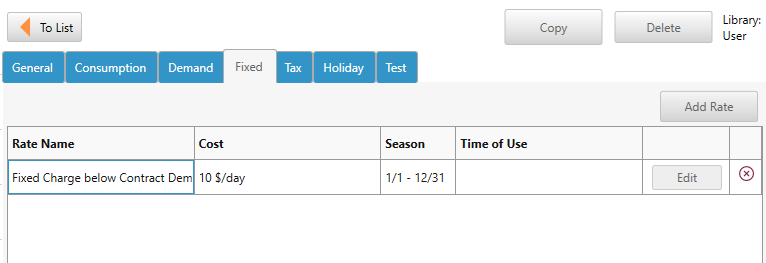

(1) A demand rate named "Fixed Charge below Contract Demand" which can be found under the demand tab. This demand charge has been created using your inputs to the first row in the table
(2) A demand rate named " Variable Charge below Contract Demand" which can be found under the demand tab.This demand charge has been created using your inputs to the second row in the table
(3) A demand rate named "Excess Charge above Contract Demand" which can be found under the demand tab.This demand charge has been created using your inputs to the third row in the table
Please do NOT try to edit these rates once they have been created by the wizard. If you want to change the values, then delete the rates, and then start over by clicking "Create New Tariff"
